Kajabi — Case Study

A 0.06% adoption rate became 164% growth in 30 days.

164%
Theme adoption increase, 30 days
21%
Active website usage ↑ (3.49% → 4.22%)
4 → 1
Clicks to apply a theme
Role
Design-Led Product Manager
Timeline
3 months
Company
Kajabi
Team
PM, Product Designer, Engineering
Kajabi theme builder interface

The problem

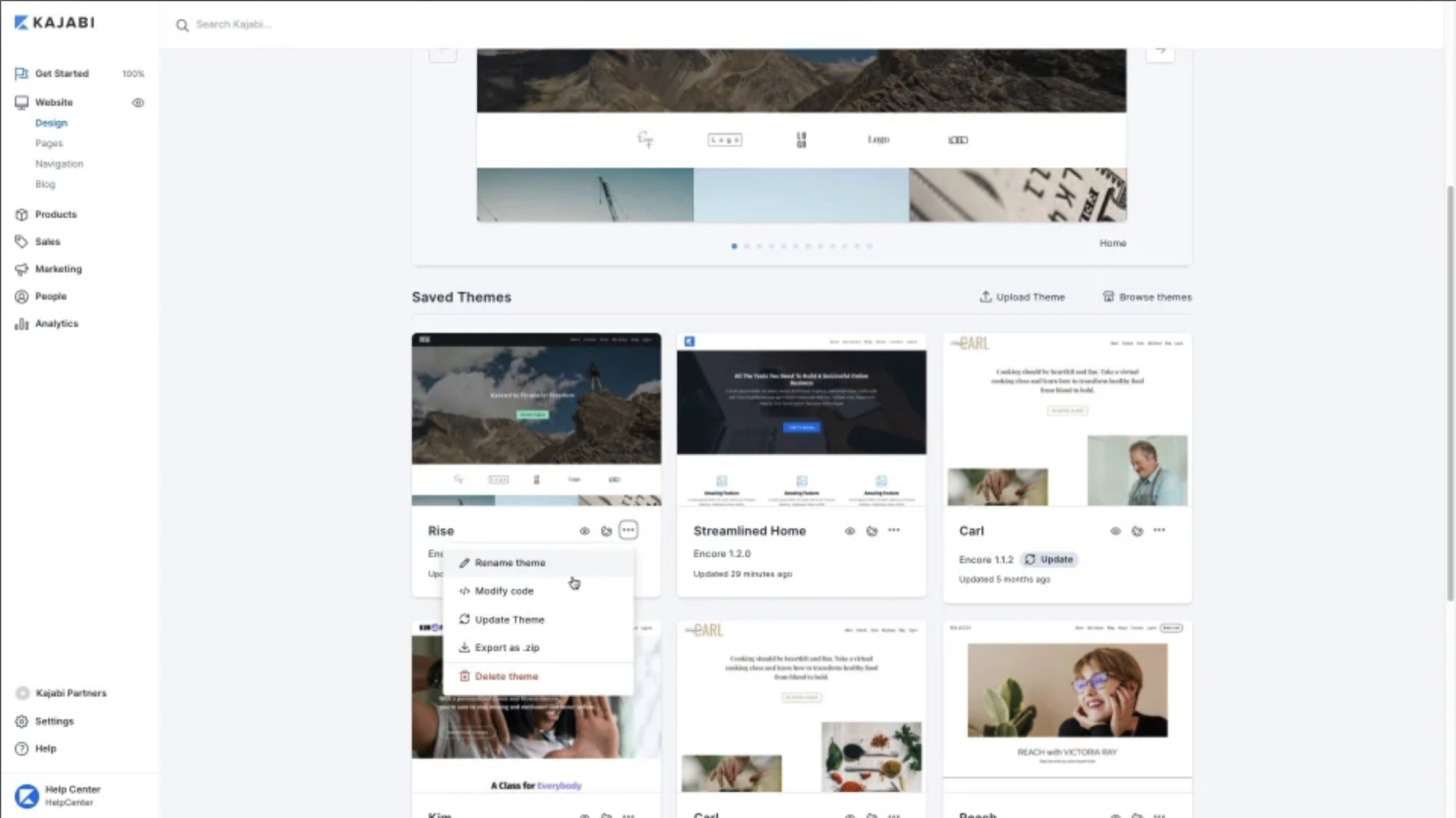

Theme updates were buried 4+ clicks deep with no preview and no feedback loop. Users described being “terrified” and “afraid I'll break everything” — so adoption sat at 0.06%. Not 6%. Point-zero-six percent. Meanwhile, 12% of all support tickets were theme-related.

The obvious fix was a full rebuild of the theme system. We didn't have the engineering runway for it — a codebase migration was already scheduled and that was the team's capacity. So the question shifted: what's the highest-impact fix we can land within what's already planned?

What I owned

  • Product strategy and prioritization across a fixed 3-month migration timeline.
  • Customer research: interviews plus analysis of theme-related support tickets (12% of all tickets at the time).
  • Cross-functional scoping — identified the highest-impact fixes within the codebase migration already in progress.
  • Established theme adoption as a tracked product KPI for the first time.

Key decisions

Decision 1

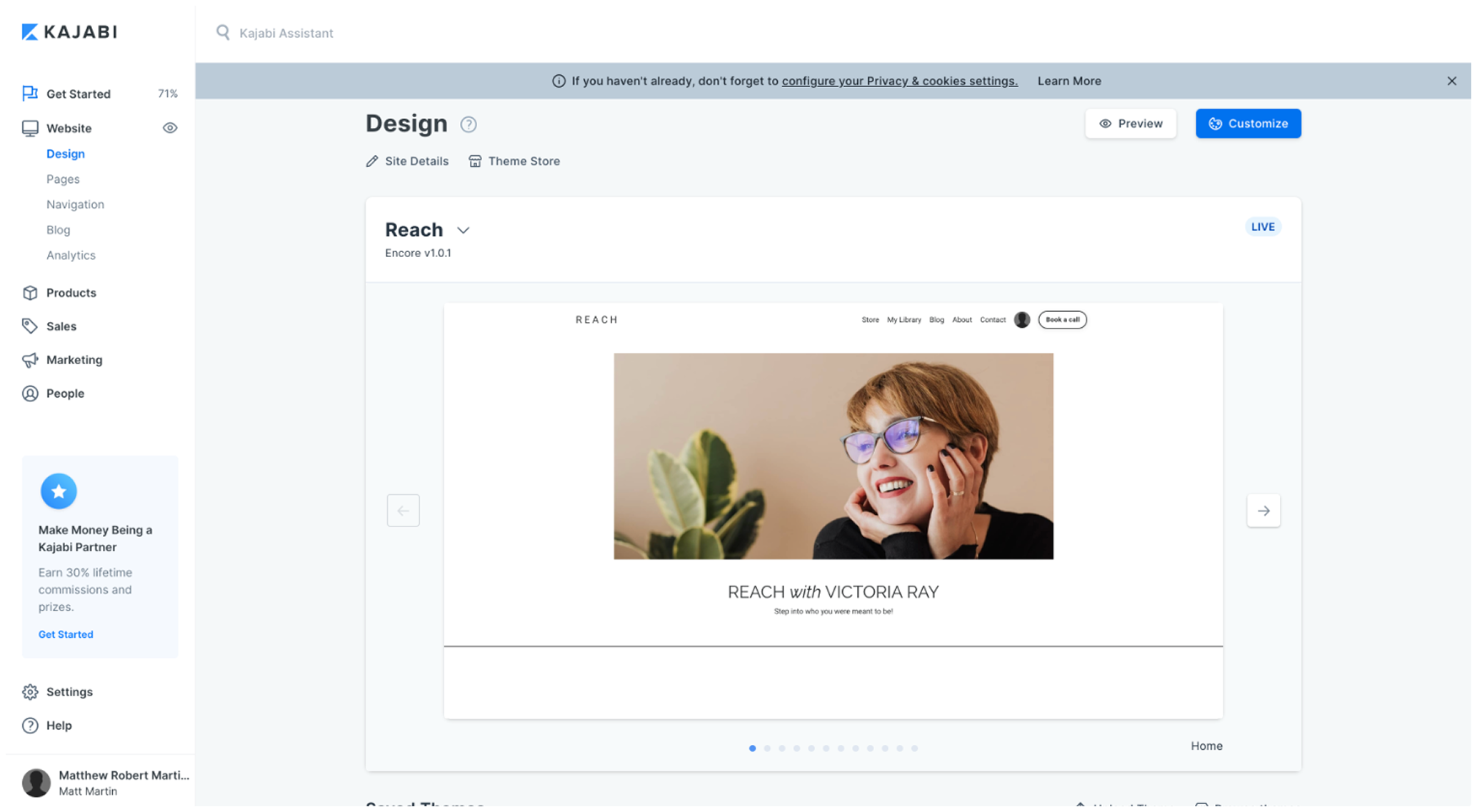

One-click apply with preview and fallback pages

Replaced the buried 4-click flow with a single "Apply Theme" action plus a confirmation/preview step, and shipped default fallback pages (404, login, forgot password) so switching themes stopped feeling dangerous. The fear of breaking something was the actual adoption blocker — not the number of clicks.

Decision 2

Scope to the migration already in progress

Rather than lobbying for separate engineering time, I scoped the fix to ride inside an already-planned codebase migration. The question was "what can we fix right now that moves the metric most," not "what's the ideal fix." This got the work shipped in 3 months instead of onto a backlog.

Outcome

  • 164% increase in theme adoption within 30 days.
  • Active website usage rose from 3.49% to 4.22% weekly.
  • Reduced theme-related support ticket volume.
  • Theme adoption became a tracked core product KPI — it had never been measured before this project.
